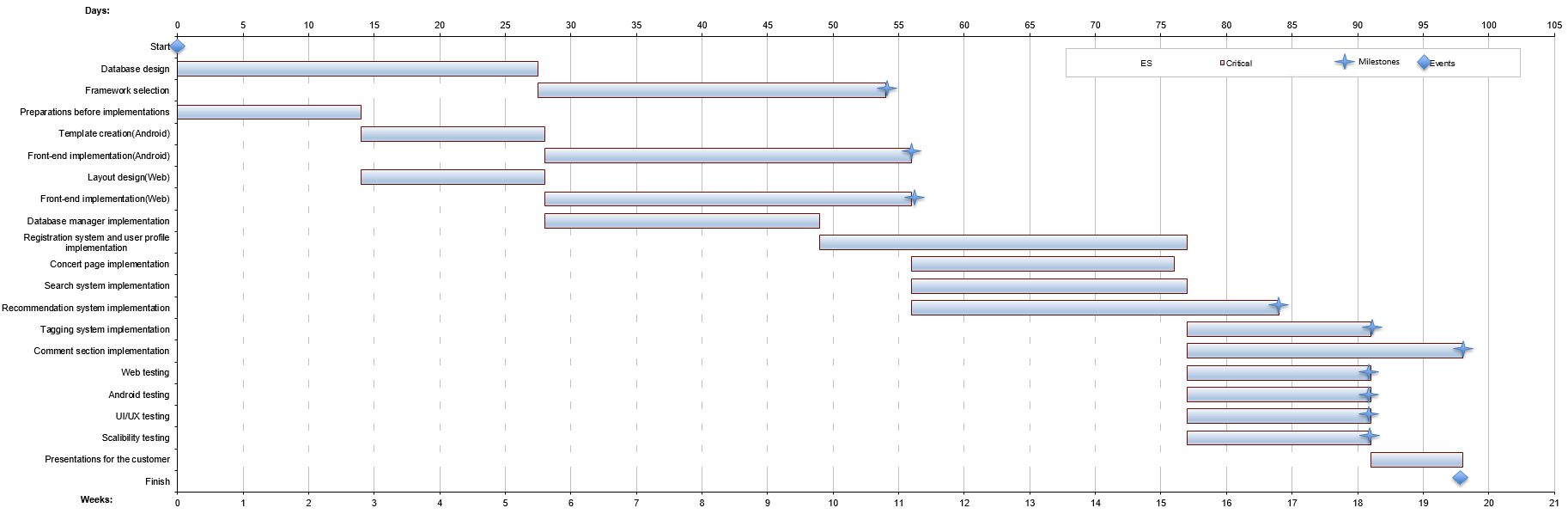

Here is our chart for the implementation Phase:

Gantt Chart

Implementation Plan (Start 18.09.2017):

System Design: (28 days | 18.09.2017 - 15.10.2017)

  • Database design (28 days | 18.09.2017 - 15.10.2017)
  • Framework selection (28 days | 18.10.2017 - 15.11.2017) MILESTONE: System design completed

Android Implementation: (42 days | 02.10.2017 - 12.11.2017)

  • Template creation (14 days | 02.10.2017 - 15.10.2017)
  • Front-end implementation (28 days | 16.10.2017 - 12.11.2017) MILESTONE: Front-end completed

Android Implementation: (42 days | 02.10.2017 - 12.11.2017)

  • Layout design (14 days | 02.10.2017 - 15.10.2017)
  • Front-end implementation (28 days | 16.10.2017 - 12.11.2017) MILESTONE: Front-end completed

Back-End Implementation: (63 days | 16.10.2017 - 17.12.2017)

  • Database manager implementation (21 days | 16.10.2017 - 05.11.2017)
  • Registration system and user profile implementation (28 days | 30.10.2017 - 26.11.2017)
  • Concert page implementation (21 days | 20.11.2017 - 10.12.2017)
  • Search system implementation (28 days | 13.11.2017 - 10.12.2017)
  • Recommendation system implementation (28 days | 13.11.2017 - 10.12.2017)
  • Tagging system implementation (14 days | 27.11.2017 - 10.12.2017)
  • Comment section implementation (21 days | 27.11.2017 - 17.12.2017) MILESTONE: Back-end completed

Testing (14 days | 27.11.2017 - 10.12.2017)

  • Web Testing (milestone) (14 days | 27.11.2017 - 10.12.2017)
  • Browser Compatibility Testing(Google Chrome, Firefox, Internet Explorer, Safari, Opera)
    -Operating System Compatibility Testing(Linux, Mac, Windows)
    -Performance testing for optimizing page load time
  • Android Testing (milestone) (14 days | 27.11.2017 - 10.12.2017)
    -Testing on different machines and android versions
  • UI/UX testing (milestone) (14 days | 27.11.2017 - 10.12.2017)
    - Testing for different screen resolutions
    - Testing for all the navigation and controls
  • Scalability Testing (14 days | 27.11.2017 - 10.12.2017)
    - Testing for maximum number of users
    - Testing for performance under a high load
    - Testing for web server request and response time

Presentations for the Customer (7 days | 11.12.2017 - 17.12.2017)

-Preparing the Presentations
-Preparing the speeches
-Preparing the demo page content (milestone)

**All the sub-parts goes paralel with the dates written for the main titles.
